What is an as-built drawing?
An as-built drawing is a revised drawing produced at the end of a construction project (or captured from an existing building) that shows the work as it was actually built — every change made during the construction process recorded against the original design. Where the design drawings say what should happen, as-built drawings say what did happen: the moved doorway, the rerouted pipework, the thickened wall, the service riser that ended up 300 mm from where the drawings promised.
On a live construction project, the duty to create as-built drawings traditionally starts with a marked-up set known as redline drawings (or red-line drawings): throughout the construction process the contractor records changes made during construction — in red pen, historically — against the original design drawings. When construction is complete, those drawings submitted by a contractor are drawn up into the final as-built drawings for the completed project. Done well, as-built drawings document what was actually built and show the building exactly as project teams left it; done badly, they show the original drawings with optimistic annotations. Modern construction technology helps — construction management and construction software platforms now capture deviations from the original design digitally during the construction phase, rather than reconstructing them from memory at the end.
For existing buildings the situation is different: there may be no reliable drawings at all. In that case "producing as-builts" means measuring the building from scratch — which is where an as-built survey comes in: the building is captured as it stands and a fresh set of drawings is produced from the measured data.
How do design drawings and as-built drawings differ — and where do record drawings fit?
Three terms get used loosely in construction and architecture, and understanding how design drawings, as-built and record drawings relate matters when you're specifying deliverables. As-built drawings in construction play a distinct role in the construction record:
- Design drawings (construction drawings) — the architect's and engineers' instructions for what to build. They reflect intent at the time of issue.
- As-built drawings — the contractor's record of what was actually constructed, including every modification, substitution and deviation from the original design, typically based on the contractor's site markups.
- Record drawings — the architect's clean, final drawing set prepared at completion, usually compiled from the contractor's as-built markups plus the architect's own knowledge of the project. In UK practice "record drawings" and "as-built drawings" are often used interchangeably, but strictly the as-builts are the contractor's record and the record drawings are the design team's synthesis of it.
One more sibling: shop drawings — fabrication-level drawings produced by specialist subcontractors (steelwork, joinery, MEP). They feed the as-built record but are not the as-built record.
The lifecycle view makes the distinctions click. Before construction begins, the design set is the only truth available. Through every phase of construction, conditions on the construction site diverge from it — substitutions, clashes resolved, client changes. Good as-built practice captures that divergence as it happens, so the final construction record reflects reality; record drawings are essential as the design team's clean synthesis of it; and the building after construction carries a documented history instead of a mystery. As-built drawings ensure the next person to open the construction documents — in the construction phase of a project or twenty years later — sees drawings that show the building, not the intention.
The importance of as-built drawings: why they're essential
As-built drawings provide the factual record every later decision leans on — as-built drawings are essential on every construction project, even when they feel bureaucratic right up until the day they're load-bearing:
- Facilities management and future maintenance — the maintenance team inheriting the building needs to know where every valve, cable route and access panel actually is. Reliable as-built drawings help turn a half-day hunt into a 20-minute isolation.
- Future renovation and modification — every future architect and engineer designs against the as-builts. Errors compound: a wrong wall position on the record set becomes a wrong assumption in the next project's design drawings.
- Compliance and safety — fire strategies, O&M manuals and (for higher-risk residential buildings) the golden thread under the Building Safety Act all depend on drawings that match the building. For HRBs, holding accurate, current building information is now a legal duty, not good practice.
- Disputes and valuations — when there's disagreement about what was built, the as-built record is the evidence.
- Asset transactions — buyers, lenders and valuers increasingly expect a reliable drawing set; producing one late, under deal pressure, costs more than producing it properly at handover.
Who is responsible for creating as-built drawings?
On a construction project, the conventional split:
- The contractor is responsible for recording changes as they happen and producing the as-built markups — this obligation is usually written into the building contract, and on design-and-build projects the contractor typically owes the employer the full as-built set
- The architect or lead designer compiles record drawings from those markups at completion
- Specialist subcontractors provide as-installed drawings for their packages (mechanical, electrical, sprinklers)
Are as-built drawings a legal requirement? In most cases they are a contractual requirement rather than a free-standing legal one — but there are real statutory edges: building control completion evidence, fire safety information that must be handed over under the Regulatory Reform (Fire Safety) Order, CDM health and safety file content, and the Building Safety Act's golden thread for higher-risk buildings. In practice, a project that closes out without as-builts has both a contract problem and a future compliance problem.
For existing buildings, responsibility is simpler: whoever needs accurate drawings commissions them. That's typically the building owner, asset manager or the design team at the start of a refurbishment — and it's done as a measured survey rather than a paper reconciliation.
What should as-built drawings include?
Precise as-built documentation is a set of drawings that represent the final building, not a tidied version of the design. A competent set records, at minimum:
- Dimensions and geometry as built — wall positions, openings, floor levels, ceiling heights, structural elements
- Every change made during construction — with the original design intent superseded, not silently overwritten
- Services as installed — pipe and duct routes, cable containment, plant positions, isolation points
- Materials and specifications where they deviated from design
- Fixtures, fittings and equipment relevant to operation and maintenance
- Dates and revision history — when the record was made and what it supersedes

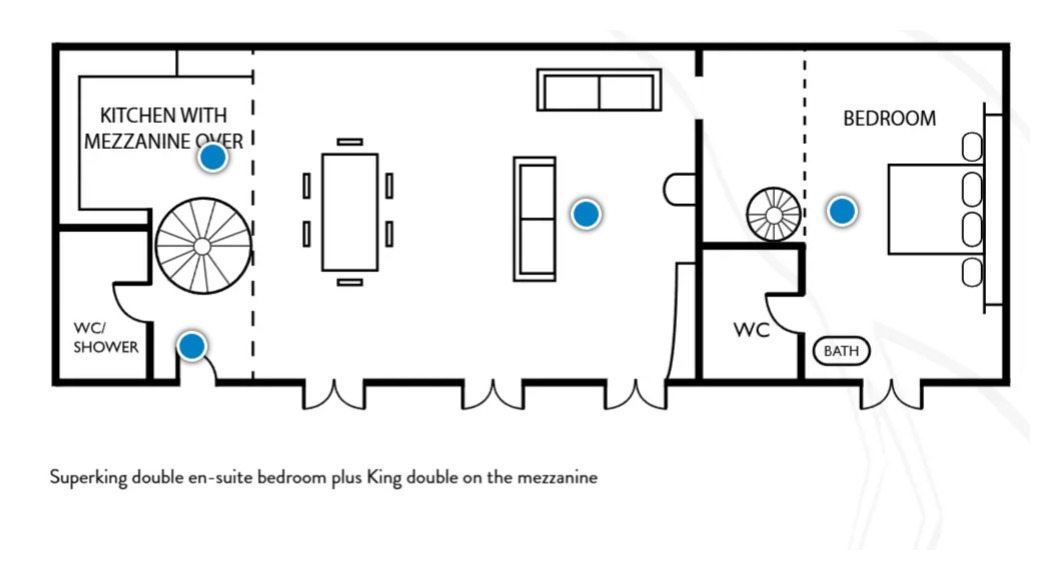

Format matters as much as content: scaled 2D CAD drawings (DWG/PDF) remain the default deliverable, increasingly accompanied by the underlying point cloud and, on BIM projects, an as-built model.
How are as-built drawings created today? Laser scanning and BIM
The traditional method — site walks, tape measures, marked-up prints, transcription into CAD — has two structural weaknesses: it only records the dimensions someone thought to take, and every manual transcription step introduces error.
Modern as-built documentation is captured with 3D laser scanning. A LiDAR scanner records the complete geometry of the building as millions of measured points — a point cloud survey — from which accurate as-built drawings are produced. We scan with the Realsee Galois M2, which pairs survey-grade LiDAR with 134-megapixel panoramic imagery at every setup, so the drawings come with a navigable 16K visual record of the building: anyone checking the as-builts can look at the actual room rather than revisiting site.
The practical advantages over manual methods:
- Completeness — everything in view is captured; a dimension nobody anticipated is still in the data when it's needed later
- Accuracy — survey-grade capture holds a few millimetres across a building, beyond what tape-and-laser methods achieve
- Speed and minimal disruption — minutes per room, routinely carried out in occupied buildings
- One dataset, many outputs — floor plans, elevation drawings, sections, area schedules and a virtual walkthrough from a single visit
Where the project runs BIM, the same scan feeds a scan-to-BIM workflow: the point cloud is modelled into Revit as an as-built (or "as-existing") building information model, so the geometry, the drawings and the asset data live in one coordinated model. For owners, BIM-based as-builts are what make the golden thread genuinely maintainable — update the model, regenerate the drawings.
How much do as-built drawings cost?
Cost follows the same drivers as any measured survey work: floor area and complexity, the level of detail required, which drawings you need (plans only, or plans plus elevations, sections and services), access constraints, and the deliverable format (2D CAD, point cloud handover, or a full BIM model). A small commercial unit needing floor plans sits at the low end; a multi-storey building needing a full drawing set with an as-built Revit model is a different commission.
Two honest rules of thumb: producing as-builts from a laser scan is almost always cheaper than the consequences of designing against wrong drawings, and capturing the record at handover — while access is easy and knowledge is fresh — costs a fraction of reconstructing it years later. We quote per project with itemised scanning and drawing stages; get in touch with your building details for a tailored figure. Scanning is typically a single visit, with drawings delivered in 3–5 working days for standard packages.
